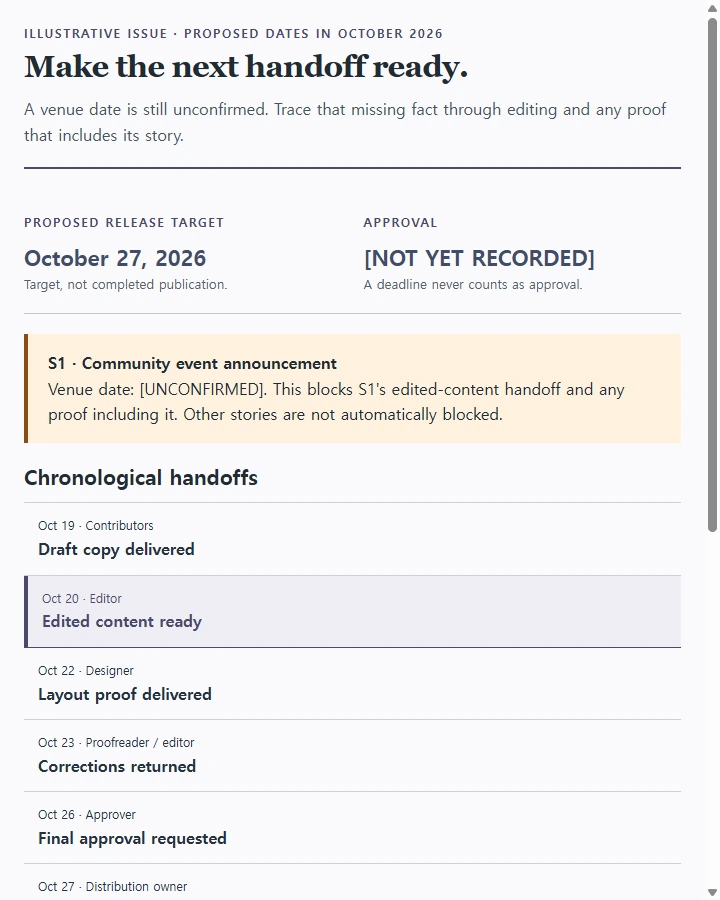

Plan the issue, not just its release date
This original illustrative issue uses a proposed October 27, 2026 release. Its dates are planning inputs, not completed publication or promised production capacity. The Resource Centre production guidance separates copy, editorial decisions, design, proof amendments, final artwork, and distribution. Adapt those handoffs to your actual print or email workflow.
| Target date | Handoff | Responsible role | Evidence required |
|---|---|---|---|
| October 19 | Draft copy delivered | Contributors | Current text and factual sources. |
| October 20 | Edited content ready | Editor | Confirmed facts and decision on included items. |
| October 22 | Layout proof delivered | Designer | The approved-for-layout content version. |
| October 23 | Corrections returned | Proofreader/editor | Consolidated corrections to the identified proof. |
| October 26 | Final approval requested | Approver | Corrected proof and actual approval decision. |
| October 27 | Target release | Distribution owner | Approved final version and confirmed delivery arrangements. |
Agree the dates with the people doing the work. These calendar dates do not establish working-day allowances, staff availability, printer lead times, or send scheduling.
Trace the unconfirmed fact to the blocked handoff
For the sample issue, Story S1 announces a community event, but its venue date is [UNCONFIRMED]. Its factual check remains open. The editor cannot label S1 ready merely because draft copy arrived on October 19.
Give the issue two explicit options: hold that story until its date is confirmed, or obtain an editorial decision to omit it from this issue. If confirmed stories proceed to layout, identify exactly which items and version the designer receives. Do not hide the incomplete story in a supposedly final content packet.
The missing fact blocks S1's edited-content handoff and any proof that includes its announcement. It does not automatically block every unrelated story. Record the scope of the blocker so the team can make a useful inclusion decision.
Keep proof, correction, and approval distinct
A proof is a version to check, not an approval. A returned correction list is work requested, not evidence that every correction was applied. After the designer produces the corrected version, compare it with the list and request the actual approval from the designated person.
Use fields such as input version; output version; target date; current evidence; unresolved decision. For October 26, the approval field stays [NOT YET RECORDED] until someone actually approves the identified version. Missing the deadline must not change the state to approved.
If a date changes, inspect the downstream handoffs and distribution arrangements. Keep the original target and revised target distinguishable where the team needs to understand the change; do not silently claim the release happened on the original date.
Prompt for an issue handoff schedule
Draft an original newsletter production schedule in US English.
Issue and release target, including year: [inputs]
Delivery method and confirmed production constraints: [inputs]
Stories/assets with known and unconfirmed facts: [inputs]
Contributor, editor, designer, proofreader, approver, distribution roles: [inputs]
Proposed or agreed handoff dates and version identifiers: [inputs]
Required editorial/source/approval record formats: [inputs]
Map copy, factual/editing decisions, layout proof, corrections, corrected final version, actual approval, and distribution. For each handoff show required input, output, responsible role, date, current evidence, and unresolved decision. Trace a missing fact to the affected story and downstream version. If other items proceed, require an explicit inclusion/omission decision and identified content packet. Distinguish due from done and approval requested from approval recorded.
Do not invent venue dates, staff availability, working-day allowances, approvals, delivery evidence, or release results. Retain original dates and label revised targets; use [NEEDED: input] visibly. Return the schedule for our original production tools. Any optional HTML review is a dated snapshot, with no sending, scheduling, payment, or automatic synchronization claim.
Before the next handoff, confirm its input version and the evidence that makes it ready. Resolve the story's date or document the omission decision, then pass only the identified content onward. Keep actual approvals and distribution evidence in the maintained production record.
Optional: review the handoff packet in NOS
If your production team already prepares a sanitized HTML schedule, NOS can save and render it so you can read the release target beside the unresolved fact and next handoff. Keep working copy, factual sources, approval records, and delivery in their original tools.
