An action plan connects a finding to a decision: what to adopt, what to defer, why, and how to check the result. Keep the recommendations you have not adopted visible. Otherwise, someone may reasonably assume that every suggestion became a commitment.
This fictional support-mailbox example turns a review finding into a bounded improvement proposal, then separates evidence that the work was done from evidence that it helped.

Begin with the problem the actions should address

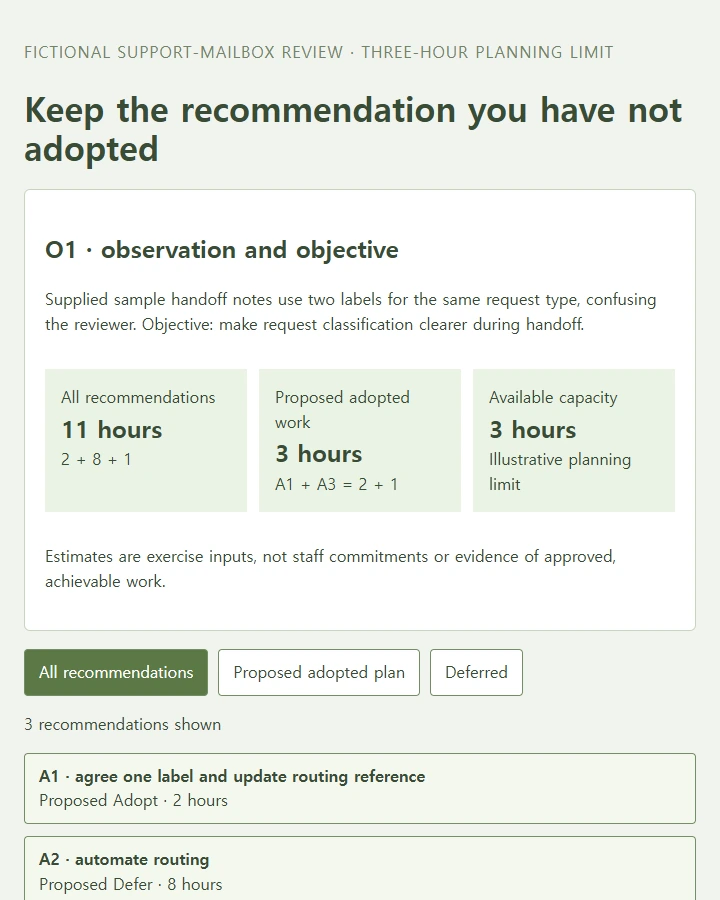

The supplied training record contains this observation, O1: sample handoff notes use two labels for the same request type, causing confusion for the reviewer. The objective is to make the request classification clearer during handoff.
The proposed recommendations are:
| ID | Recommendation | Illustrative effort estimate |
|---|---|---|
| A1 | Agree one label and update the routing reference | 2 hours |
| A2 | Automate routing | 8 hours |
| A3 | Refresh the examples that explain the label | 1 hour |
The supplied planning capacity is three hours. These are exercise estimates, not a staff commitment or an estimate generated from a connected mailbox.
FEMA's action-planning guidance makes adoption decisions and their rationale explicit, then connects accepted actions with responsibilities, timing, and later measures of effect. The ordinary workplace example here applies those planning principles without importing emergency-management requirements. Read the action-planning guidance.
Make the adoption decision visible
The proposed plan adopts A1 and A3: two hours plus one hour equals the three hours available. It defers A2 pending a feasibility review and additional capacity.
| Action | Proposed decision | Reason and dependency |
|---|---|---|
| A1 | Adopt | Clarifies the reference within the available capacity. Actual owner and date still need agreement. |
| A2 | Defer | Its eight-hour estimate exceeds the current allocation; feasibility is also unresolved. Retain it for reconsideration. |
| A3 | Adopt after A1 | Examples should use the agreed label, so A1's wording must come first. Actual owner and date still need agreement. |
The full recommendation set is 2 + 8 + 1 = 11 hours. The adopted proposal is 2 + 1 = 3 hours. Showing both totals explains the choice more clearly than quietly removing automation from the table.
A three-hour total does not prove the proposal is approved or achievable. It shows that the supplied estimates fit the planning limit. The people responsible still need to confirm the work, wording, and timing.
Define two different checkpoints
Suppose the model checkpoint supplies routing-reference version R2 for A1. That is evidence that a revised document exists. It does not show that colleagues used it correctly during later handoffs.
Use separate records:
- Implementation check: Is the agreed reference revision available, and does it contain the intended label? The example supplies R2 for inspection.
- Effectiveness check: After rollout, can reviewers classify a new permitted sample consistently using the revised reference? No later-use evidence is supplied yet.
Leave the effectiveness result unknown. Do not fill it with “successful” because the document is complete. Decide who will review an appropriate later sample and when, then add the result when it exists.
This distinction also helps when a change fails to produce the hoped-for improvement. You can ask whether the action was implemented, whether people encountered it, and whether it addressed the original confusion, rather than reopening every recommendation at once.
Use the working plan
Switch between all recommendations and the adopted/deferred proposal. Inspect A3's dependency on A1, check both effort totals, and open the implementation and effectiveness checkpoints to see what each needs.
Use the blank plan to enter your own observation, recommendations, estimates, decisions, reasons, dependencies, and evidence questions. Keep review notes while changing views. Confirm before resetting them. A status control changes the working record; it cannot create another person's agreement.
Copy this prompt for your review
Create a complete self-contained HTML action-planning worksheet.
My observation/objective: [details]. Recommendations and effort:
[items]. Available capacity: [amount/unit]. Decisions/rationale:
[agreed facts or proposals]. Owners/dates: [confirmed or unknown].
Include a separate fictional support-mailbox case. O1: supplied sample
handoff notes use two labels for the same request type, confusing the
reviewer. A1 agree one label/update routing reference, estimate2hours;
A2 automate routing, estimate8hours; A3 refresh examples, estimate1hour.
Capacity3hours. Propose A1+A3=3hours and defer A2 pending feasibility
and capacity. All recommendations total11hours. A3 depends on A1's
wording. Retain deferred A2 and its reason. Owner/date still to confirm;
do not invent approval, commitments, or live email integration.
Let readers switch all-recommendations/adopted-plan views, inspect
reasons/dependencies, and compare accurate effort totals. Supply
checkpoint R2: revised routing reference exists, but later use evidence
is absent. Separate implementation evidence from effectiveness. The
proposed later check examines classification of a new permitted sample;
no outcomes or sample results supplied. Provide a blank plan, named
missing-objective/decision feedback, retained temporary notes across
views, and confirmed reset. No checkbox implies external agreement.
Use system fonts at least16px, labeled keyboard-accessible controls,
visible focus, and 360px layout without horizontal scrolling. Inline
CSS/JavaScript, no dependencies. Return complete HTML.
Take one unresolved decision into the review
Before assigning dates, ask the relevant lead whether A1 and A3 are the changes they want to adopt. Share the prepared plan in NOS with the deferred recommendation still visible. The reviewer can assess the resource choice and dependency together, rather than responding to a task list that already appears committed.
