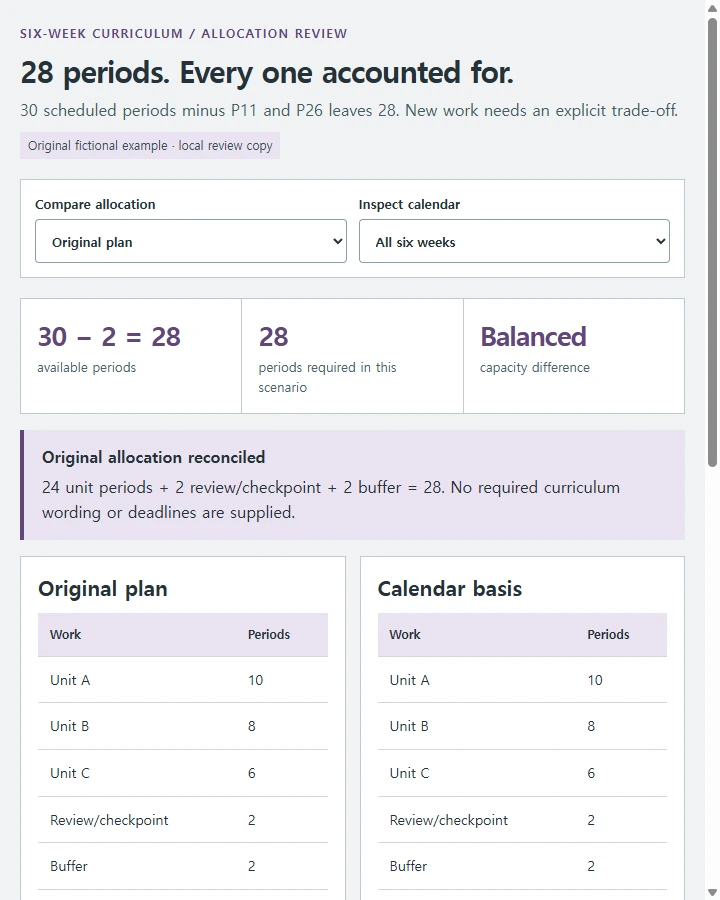

Begin with the calendar you actually have
This original fictional block numbers its scheduled periods P01-P30. P11 and P26 are supplied non-instructional periods. The remaining 28 periods are available for the plan. No real school calendar or required standard is inferred.
| Week | Scheduled identities | Non-instructional | Available identities |
|---|---|---|---|
| 1 | P01-P05 | None supplied | P01-P05 |
| 2 | P06-P10 | None supplied | P06-P10 |
| 3 | P11-P15 | P11 | P12-P15 |
| 4 | P16-P20 | None supplied | P16-P20 |
| 5 | P21-P25 | None supplied | P21-P25 |
| 6 | P26-P30 | P26 | P27-P30 |
Calendar analysis, unit allocations, checkpoints, and flex time are included in the Flip Education pacing scaffold. The Central Valley district resource index also lists a pacing-guide template and example. The allocation here is original; it does not reproduce those files or impose a buffer policy.
Allocate every available period once
| Planned work | Period identities | Count |
|---|---|---|
| Unit A | P01-P10 | 10 |
| Unit B | P12-P19 | 8 |
| Unit C | P20-P25 | 6 |
| Review/checkpoint | P27-P28 | 2 |
| Buffer | P29-P30 | 2 |
The units total 24 periods; two review and two buffer periods bring the allocation to 28. Keep P11 and P26 visible as unavailable instead of accidentally filling them with instruction. Add your required content and assessment deadlines beside the actual units, using supplied curriculum wording.
Compare the original plan with a proposed change
A new three-period project would raise the requirement to 31 periods if nothing else changes. The current calendar still provides 28: the proposal is three periods over capacity. Using both buffer periods leaves a one-period gap and removes the flexibility you reserved.
Record a decision question: “What authorized change provides the remaining period while preserving required content and deadlines?” Options might involve additional confirmed time or a revised task approved by the responsible curriculum team. Do not silently cut Unit C or the review checkpoint to make the arithmetic balance.
If Unit A instead takes one extra period, show a conditional revised allocation: A eleven, B eight, C six, review two, buffer one, totaling 28. Remap the actual period identities and recheck content deadlines before adopting it. That version consumes one buffer period; it does not prove the calendar or learning outcomes improved.
Copy a pacing-review prompt
Create an original curriculum pacing guide in US English.
Calendar with stable period/week identities: [inputs]
Confirmed non-instructional periods: [inputs]
Units, sequence, required content and deadlines: [inputs]
Unit allocations, assessments/review, and buffer time: [inputs]
Proposed addition or delay: [inputs]
Required district planner format and decision authority: [inputs]
Count scheduled minus supplied unavailable periods, then allocate each available period exactly once. Show unit/week identities and reconciled totals. Preserve original plan beside conditional change, showing affected units, review, buffer and deadlines. Expose any overscheduling; do not invent additional periods or approve curriculum cuts. Separate time assumptions from actual assessment evidence.
Do not invent standards, calendar losses, deadlines, results, or a universal buffer minimum. Use [NEEDED: input] for gaps. Describe optional local unit/week inspection without claiming automatic standards validation or approved changes. Return the required district planning format; any HTML comparison supplements the maintained plan.
Review the adjustment with a colleague
If your team prepares the calendar/allocation comparison as HTML, NOS can save and render it while you inspect the lost periods and proposed changes together. Keep the district planner and curriculum decisions authoritative. End the review with a reconciled set of period identities and a clearly recorded decision on the time the new work needs.
