Separate the project from the result claim
This template is for a client or project case study. Academic assignments and research protocols may require a different method and format. Follow that requirement when it applies.
The fictional Juniper Ceramics case documents a copywriter revising sizing guidance on six product pages. It shows the work performed, two assumed four-week observation windows and a limits note. The client, events and numbers are invented; they are not a real success story or testimonial.

Show the denominator beside the count. The before window has 40 sizing-related email threads and 200 orders: 20 threads per 100 orders. The after window has 24 threads and 240 orders: 10 per 100. The thread count fell 40%, while the rate fell 50%. Those are different statements, and neither proves the rewrite caused the change.
Make the work inspectable

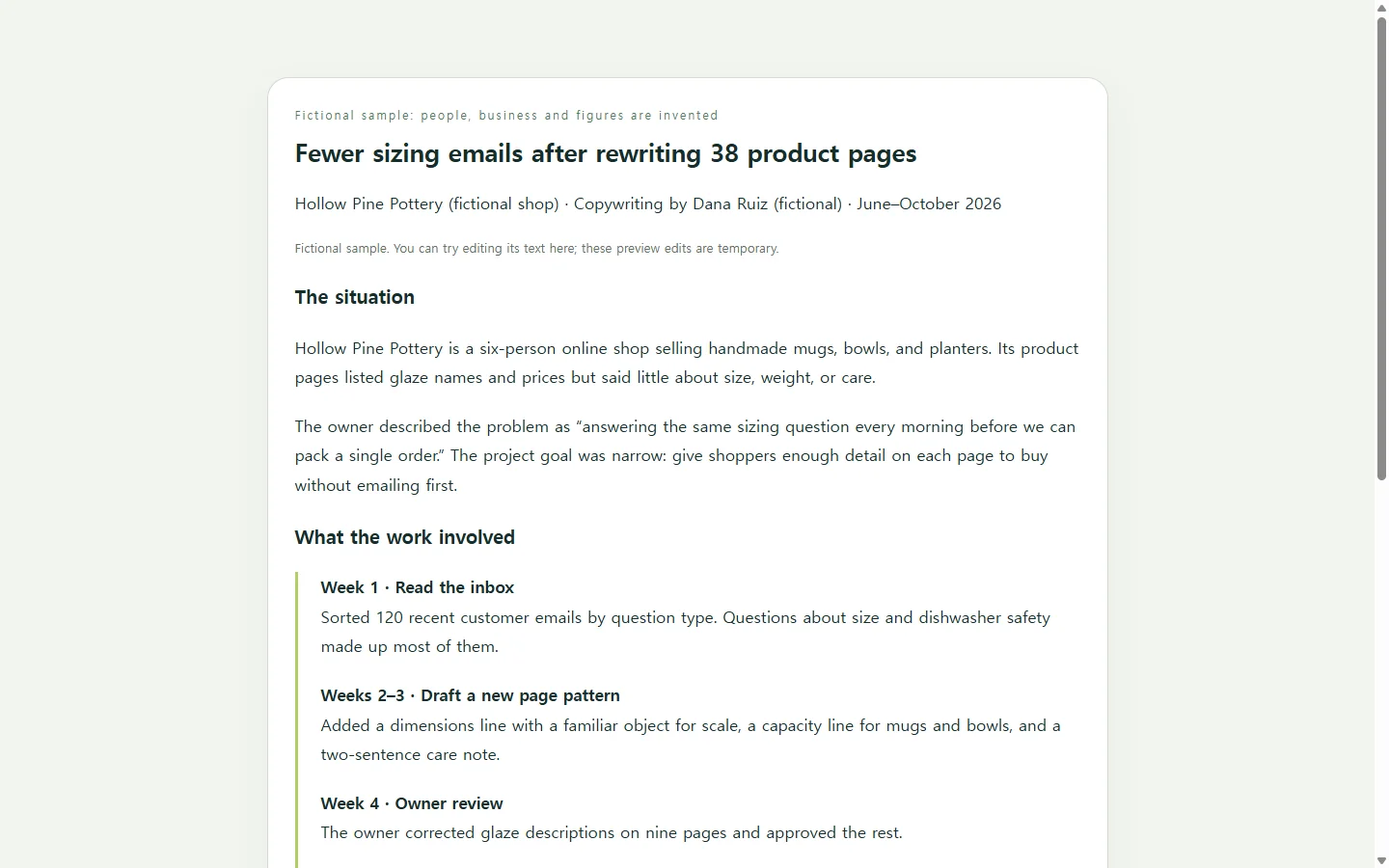

The timeline records a question review, the six-page rewrite and publication. An original demonstration excerpt shows a packing-size instruction that the writer changed. A reader can inspect what was written instead of relying on a label such as “optimized content.”
HubSpot’s case-study documentation describes a body covering the customer’s challenge, solution and results. Use that structure for your own permitted facts; the prepared example does not use HubSpot or claim access to its tools.
State what the comparison leaves open
Both windows cover four weeks, but order volume differs and a promotion ran during the after period. The figures count tagged email threads, not individual customers or every support contact. There is no control group or attribution analysis. Report an observed difference with those limits rather than writing that the project delivered a proven reduction.
Use client names, quotations and work excerpts only with permission. Keep a required case-study PDF, slide deck or report in its formal workflow.
Create a self-contained HTML client-project case-study review.
Project, audience and naming permission: [PASTE]
Problem and permitted original notes: [PASTE]
My work, dates and actual permitted excerpt: [PASTE]
Before/after: [DATES | METRIC DEFINITION | COUNT | DENOMINATOR IF RELEVANT]
Other changes, known limits and approved quotation if any: [PASTE]
Required delivery format: [PASTE]
Use only supplied facts. Do not invent clients, quotes, work, metrics, dates, permissions or causality. Show missing facts as [TO CONFIRM]. Define observation windows and the counted unit. Preserve counts and denominators; calculate rates and count/rate changes separately, showing arithmetic. Flag unequal windows, zero denominators and conflicting figures rather than guessing. Label assumptions and keep limits beside results. A before/after difference alone must not be called a proven causal effect.
Use clear headings for challenge, work, results and limits, an ordered work timeline, actual text excerpt and a captioned comparison table with scoped headers. At least 16px body text; at 360px stack labeled rows and wrap code/text without page overflow. Keep CSS in the file. No external assets, scripts, network, forms, fake metrics animations, copy/save or live analytics. Return HTML and unresolved evidence. Retain permissions and the required formal format.
Correct the claim after a reader’s question
Ask the project owner what the table actually counts. If they mean customers rather than threads, correct the definition before recalculating. Open the HTML review copy in NOS to read the result claim alongside its counts and limits, then revise the maintained case study from the confirmed source data.
Send the corrected case and identify the changed measure. Ask the owner to confirm the wording and publication permission before using it in a pitch.
