Report the movement, not just the current label

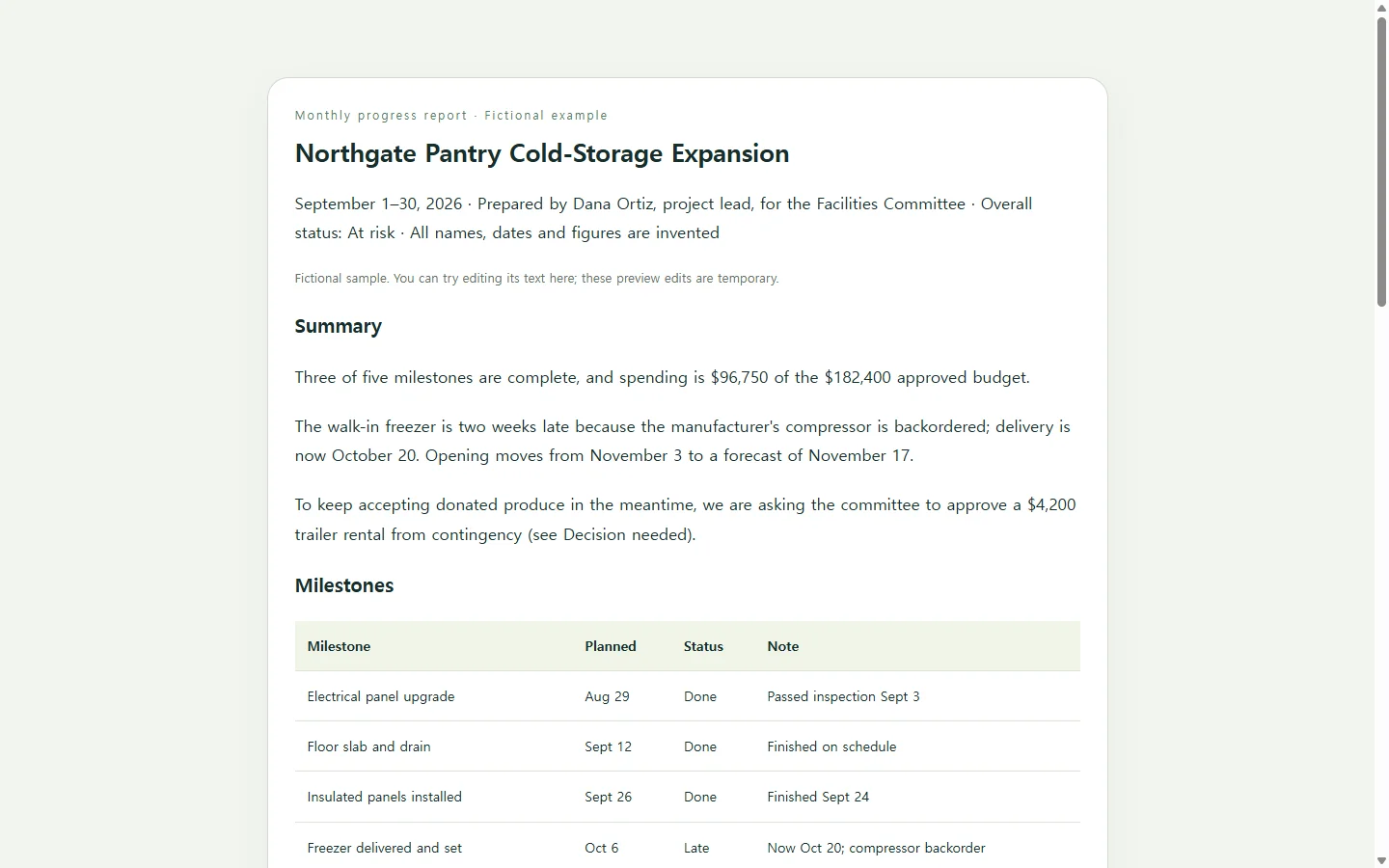

The fictional Northgate Pantry report covers September 14 through October 13, 2026. During that period, the team completed its layout review and supplier selection. Installation remains a forecast, dependent on the sponsor approving a revised work window by October 15.

Show the baseline, the new forecast and the reason on the same row. The installation row retains October 19 as its baseline and October 22 as its conditional forecast, a three-calendar-day movement. The report does not replace the baseline or describe the new date as approved.
Explain what actually moved forward
The completed-work section names the two finished milestones and their illustrative evidence: layout revision B accepted September 25 and supplier selection recorded October 2. Those entries explain what changed since the start of the period. They do not turn two completed milestones into an invented overall completion percentage.
Asana's reporting guidance treats a reporting template as a structure for progress, risks, challenges and next steps. Use that structure to connect the work accomplished during your period to the actions still needed, rather than copying another product's automated reporting claims into a static document.
Give a delay an owner and a decision date
The report asks sponsor Maya to confirm the revised work window by October 15. Project lead Owen will then seek confirmation of the October 22 installation slot. If approval misses the decision date, Owen must obtain a new forecast; the sample does not assume the slot will remain available.
Phrase the request so the recipient can answer it: “Approve or reject the revised installation window by October 15.” Keep actual approval in the project's agreed decision record. Reading this report is not acceptance of the change.
Separate cash paid from unpaid commitments
The illustrative USD budget is $8,000. Paid costs are $3,200 and committed-but-unpaid costs are $2,400. The known exposure is $5,600, leaving $2,400 unallocated against this budget. Unallocated is not a saving or a forecast of the final cost; remaining work costs are [TO CONFIRM].
Use the accounting and project records for actual transactions and approvals. If the sponsor requires a report in a particular spreadsheet, PDF or Word format, submit that format.
Draft from the period's evidence
Create one self-contained HTML project progress report review copy.
Project, reporting period, report date, lead and recipient: [PASTE]
Previous commitments and baseline milestone dates: [PASTE]
Work completed during the period with actual dates and supplied evidence: [PASTE]
Current forecasts, assumptions, reasons for movement and dependencies: [PASTE]
Decisions needed: exact request, decision owner, deadline and consequence of no answer: [PASTE]
Budget currency, approved budget, paid costs, committed-but-unpaid costs and forecast inputs: [PASTE]
Authoritative records and recipient's required report format: [PASTE]
Preserve baseline and source values. Distinguish actual dates from conditional forecasts; calculate calendar-date movement. Recompute financial totals, flag conflicts and leave missing inputs [TO CONFIRM]. Invent no approvals, vendors, evidence, completion percentages or savings. Do not double-count paid amounts as unpaid commitments. Label illustrative data.
Show period accomplishments, a baseline/actual-or-forecast table, decision request and budget categories. Use at least 16px body text and captioned tables with scoped headers and labeled stacked rows at 360px. Local CSS only; no scripts, network, external assets, editing, approval buttons or fake controls. Return HTML and unresolved items. Keep approval and accounting in their original systems.
Send the report with the question that needs an answer
Send Maya the report and the October 15 request together. If the date movement is unclear, read the baseline, conditional forecast and dependency together in the prepared HTML report in NOS, then correct the maintained report and decision record.
Tell the sponsor what changed and ask for an explicit response. Once the decision is recorded, give the team the confirmed next step and revise the next reporting period's starting assumptions.
