Start with the source rows behind the summary
The fictional Larkspur Studio office-move dashboard is a snapshot at the end of October 13, 2026, using local calendar dates. Its eight tasks contain two done, three in progress, one blocked and two not started. The display makes those counts visible with text labels and a small bar view.

A summary should let the reader find the rows that explain it. Two done tasks divided by eight tasks gives 25% by task count. It is not 25% of effort, budget or the work needed to finish the move. The sample has no task weights and does not manufacture them.
Define overdue before you color a row
For this example, a task is overdue when it is not done and its due date is earlier than the October 13 snapshot date. A task due October 13 is due today, not overdue under this rule. The blocked floor-plan approval was due October 12, so it is the one overdue open task.
The statuses and overdue condition overlap: a blocked task can also be overdue. Do not add “overdue” as a ninth task or sum it with the mutually exclusive status counts. The source table preserves task IDs, owners, due dates and the blocker that needs action.
Smartsheet's dashboard examples place task data alongside timelines and status summaries. Borrow the connection to the source table. This HTML sample is a prepared snapshot, not a live connection to a spreadsheet or a project service.
Put the next decision where the team can see it
Maya owns floor-plan approval; Owen needs the decision before confirming the furniture booking. The decision queue names that dependency and requests a response by October 14. The October 23 move date is a target, not a confirmed forecast while approval and booking remain unresolved.
Before the next review, update the source task list and produce a new dated snapshot. Keep task changes, bookings and actual approvals in the maintained project system. If dates or statuses are missing, show them as [TO CONFIRM] and explain how unknowns affect the counts.
Build a dashboard from an inspectable task list

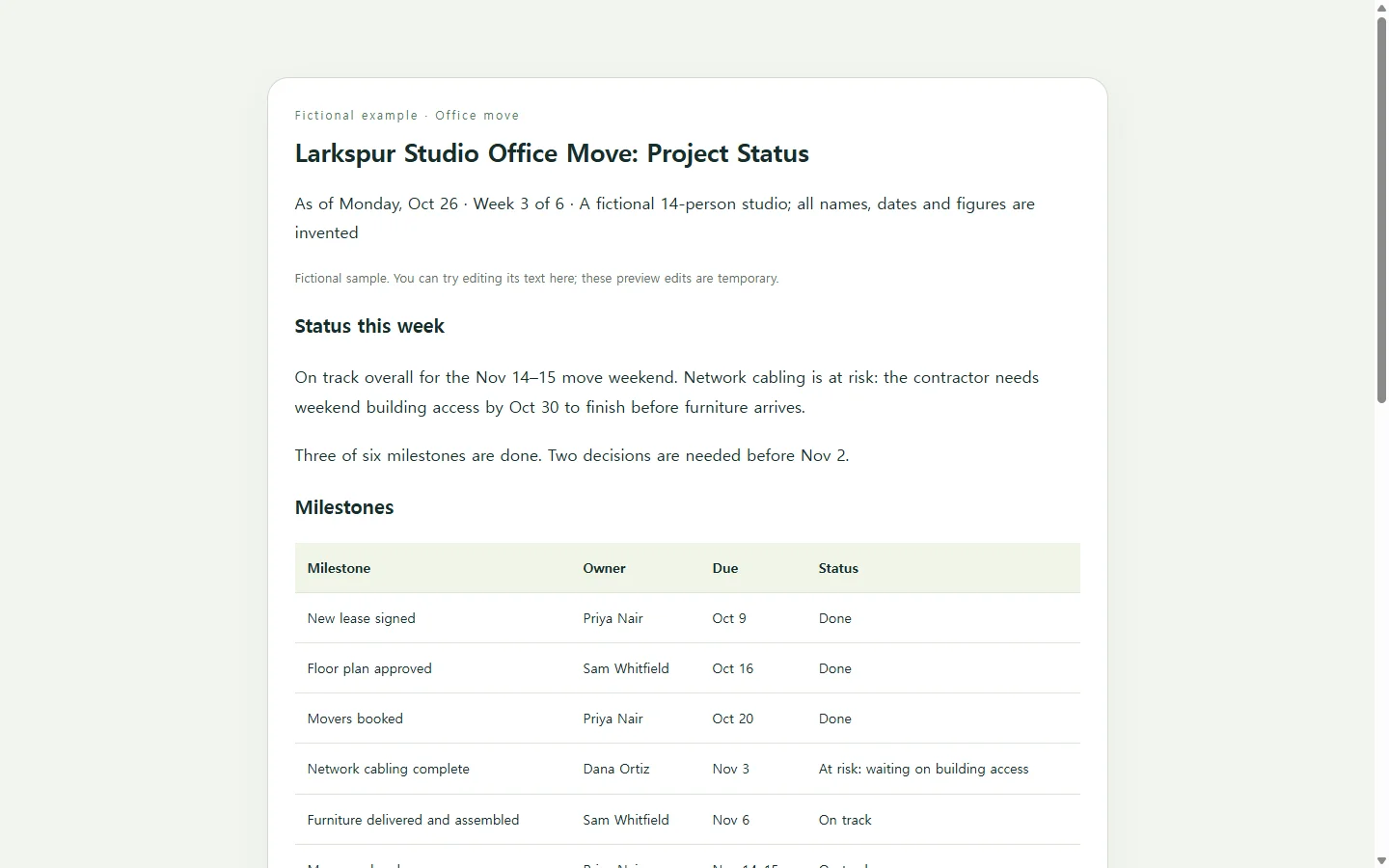

Create one self-contained HTML project dashboard review copy.
Project, snapshot date, time zone/date convention and target milestone: [PASTE]
Source tasks: [ID | TASK | OWNER | DUE DATE | STATUS | BLOCKER / EVIDENCE]
Allowed mutually exclusive status labels: [PASTE]
Confirmed task weights if any, otherwise use task-count completion: [PASTE]
Overdue rule, missing-date treatment and decision queue with owner/deadline/dependency: [PASTE]
Maintained project system and required reporting format: [PASTE]
Use only supplied rows and facts. Check unique task IDs, valid dates, allowed statuses, totals and denominator. Recompute completion and overdue counts; show conflicts without silently changing source data. Distinguish overlapping flags from exclusive statuses. Use [TO CONFIRM] for missing fields; explain any unknowns omitted from a calculation. Invent no weights, approvals, source links or live integrations. Label illustrative snapshots.
Show the summary, decision queue and complete source table. Pair any chart with its labels and numeric values. Use at least 16px body text, semantic headings and captioned tables with scoped headers and labeled stacked rows at 360px. Local CSS only; no scripts, network, external assets, native editing or fake filter/refresh controls. Return HTML and unresolved facts. Keep the authoritative task and approval records in their original system.
Ask which row would change the next action
Review the overdue approval row and its decision dependency together in the prepared HTML dashboard in NOS. Ask the project lead whether resolving that approval is enough to confirm the booking, or whether another missing input still prevents it. Record the answer in the maintained task list.
Send the next dated snapshot with the action you changed. Ask the decision owner to respond to the unresolved request; a revised dashboard does not itself provide approval.
