Your project kickoff agenda should let someone answer four practical questions: What are we delivering? Who can accept it? What do they need to inspect? What dependency could stop the first handoff?

Put scope beside acceptance

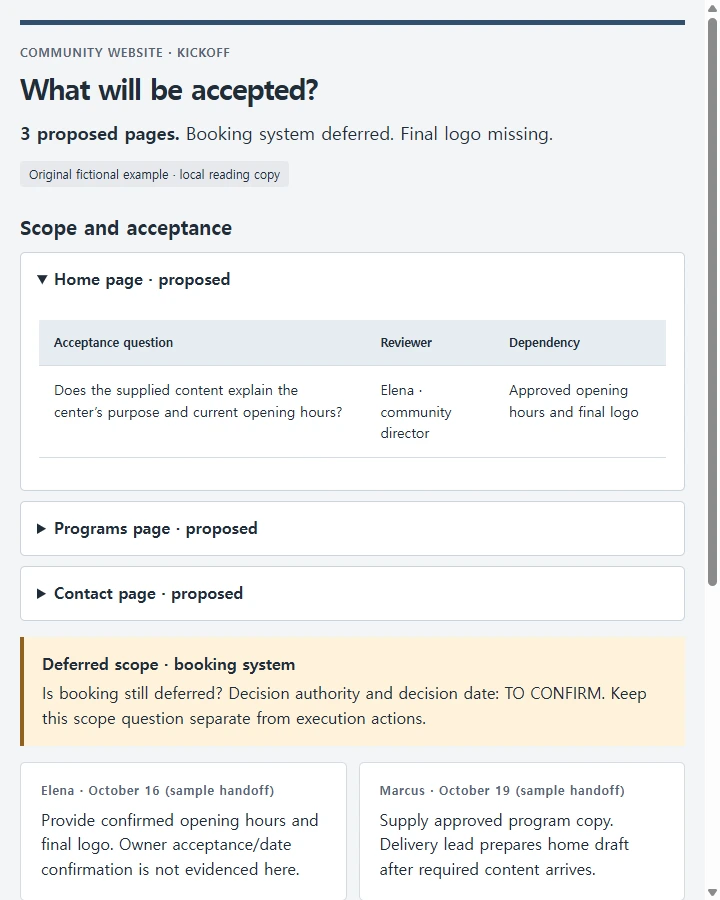

Illustrative example: a fictional community website refresh. Names, dates, scope, and dependencies are sample inputs. The proposed work includes the home, programs, and contact pages. A new booking system is deferred. The final logo file is missing.
| Proposed deliverable | Acceptance question | Reviewer | Dependency |
|---|---|---|---|
| Home page | Does the supplied content explain the center's purpose and current opening hours? | Elena, community director | Approved opening hours and final logo |
| Programs page | Does each supplied program have the correct description and contact route? | Marcus, program lead | Program copy approved by its owners |
| Contact page | Are the address, phone, and inquiry route correct in the delivered page? | Elena | Confirmed contact details |
The table is a proposal for discussion, not proof that anyone approved the work. Keep “booking system: deferred from this refresh” beside it. If the director wants booking included, the team must discuss the changed scope and its dependencies instead of treating it as a small wording correction.
Acceptance questions should fit the deliverable. “Looks good” is difficult to act on. “The opening hours match the approved copy” names something a reviewer can inspect. Add any required technical or contractual acceptance conditions from the real brief; do not infer them from this example.
A 55-minute kickoff for the sample project
- Purpose and participants, 5 minutes. State why the site is being refreshed and identify the people who can settle content and scope questions.
- Deliverables and exclusions, 15 minutes. Review the proposed pages and the deferred booking system. Mark each boundary agreed, unresolved, or changed.
- Acceptance and roles, 10 minutes. Confirm who supplies content, who builds, and who accepts each deliverable. A person attending the meeting is not automatically its approver.
- Dependencies and first milestone, 10 minutes. Locate the missing logo and agree what work can proceed while it is outstanding.
- Risks and open questions, 8 minutes. Assign a route for resolving matters that cannot be answered in the room.
- First-week handoffs, 7 minutes. Read the actions back with owners, due dates, and the information each recipient needs.
These timings are an example allocation. If scope needs more discussion, shorten the background overview or schedule the remaining delivery details separately. Preserve enough time to read back the boundaries and next handoffs.
Do not let unresolved scope hide in an action list
“Elena to send logo” is actionable. “Team to figure out booking” is a scope decision disguised as a task. Give that decision its own entry: Is booking still deferred? Who decides? By when must the delivery plan reflect the answer?
In the sample first-week handoff, Elena will provide confirmed opening hours and the final logo by October 16. Marcus will supply approved program copy by October 19. The delivery lead will prepare a home-page draft after the required content arrives. If the logo date remains unconfirmed, display date to confirm rather than inventing a deadline the owner never accepted.
Read each page's acceptance question beside its reviewer and dependency. Keep the proposed or approved status attached to that row, including when you add more review detail. Compare the included pages with the deferred booking work before reading the first-week actions; that is where a scope mismatch becomes visible.
Generate your kickoff packet
Write a project kickoff agenda and discussion packet in US English.
Project purpose: [enter]
Meeting duration and attendees: [enter]
Proposed deliverables: [paste]
Already approved scope, with reference: [paste or NOT SUPPLIED]
Excluded or deferred work: [paste]
Content providers, delivery roles, and approvers: [paste]
Acceptance conditions from the brief or contract: [paste or NOT SUPPLIED]
Dependencies, dates, and first milestone: [paste; distinguish confirmed dates]
Authoritative brief and project tracker: [enter]
Create a timed agenda for purpose, scope, acceptance, roles, dependencies,
open questions, and first-week handoffs. Times must sum to the meeting length.
For each deliverable, pair an acceptance question, responsible reviewer, and
dependency. Preserve supplied acceptance conditions; label any suggested
addition PROPOSED. Do not invent approvals, requirements, budgets, dates,
or owner agreement. Use TO CONFIRM fields where information is missing.
Separate unresolved scope decisions from execution actions.
Return the text packet plus an optional HTML reading version that exposes
deliverable acceptance details and compares in-scope with deferred work.
Keep approval status visible. Do not add project synchronization or imply
that an HTML copy changes the contract or authoritative project record.
Read the packet with the people doing the handoff
Have the content provider and delivery lead read one row together. The provider should know what to send; the lead should know what the reviewer will inspect. Resolve a mismatch before calling that row ready.
If the packet is also prepared in HTML, NOS can save and display it during this review. After the kickoff, record accepted boundaries in the approved brief and first-week actions in the project tracker. Leave the delivery lead with the next input, its owner, and the acceptance question it supports.
