Project Status Report Template: Compare the Weekly Decision

A shelving delay has reached the sponsor: spend another $2,400 to protect opening day, or move reopening by two weeks? Put that decision beside its deadline before listing the week’s completed tasks.

Put the decision where the sponsor can find it

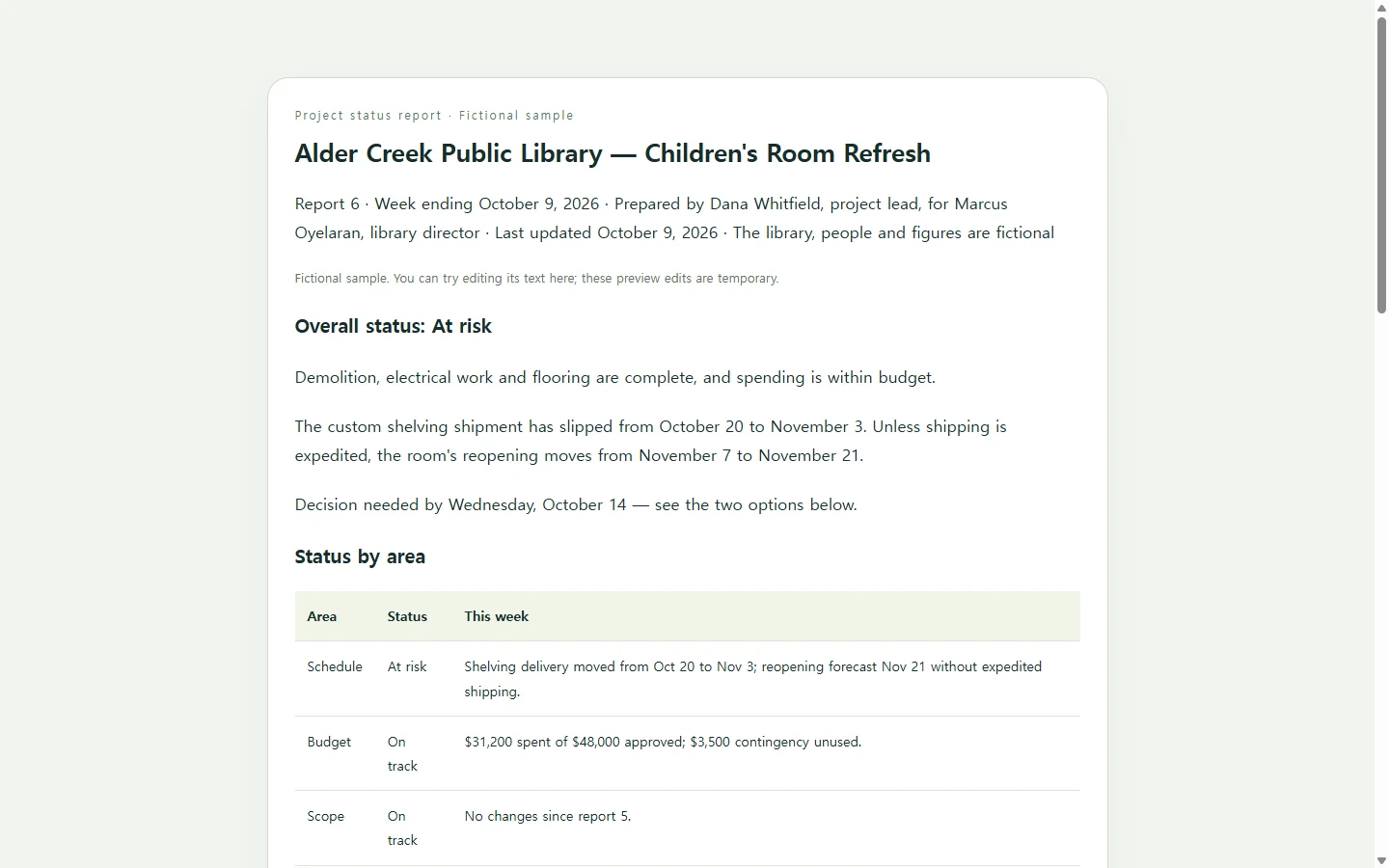

The fictional Alder Creek Library update covers October 5-9, 2026. Shelving delivery has moved from an October 9 baseline to an October 23 forecast. The sponsor, Mel Chen, needs to choose a reopening approach by October 12; neither option is approved or booked in this illustrative report.

Alder Creek: weekly status, conditional options, milestone baselines and next actions
Alder Creek: weekly status, conditional options, milestone baselines and next actions
Open the full example ↗

Keep the original date beside the current forecast. Delivery shifts 14 calendar days. Installation moves from October 12 to October 26, also 14 days. Those comparisons explain the escalation without an invented percentage complete.

Compare options without recording a decision

Option A seeks to keep November 7 reopening with $2,400 in additional expedited shipping. It requires the supplier to confirm an earlier delivery and the team to confirm installation and inspection slots. The option is a conditional recovery plan, not a confirmed forecast.

Option B targets November 21 reopening at the standard shipping rate: 14 calendar days after the November 7 baseline, with no extra shipping charge in the sample assumption. Other reopening costs are [TO CONFIRM], so the page does not call this a total project saving.

This is a current weekly decision view. The period progress report serves a different need: comparing work completed across a reporting period and the next period's commitments. Do not make a sponsor read a monthly history to answer a time-sensitive question.

State what changed, who acts and what remains unknown

The sample says the floor preparation passed its internal review on October 8, while shelving delivery remains at risk. Jo Patel will request supplier dates by October 12; Luis Park will check installation and inspection availability by October 13. Mel's decision determines which option the team plans against.

Asana's status report guide describes a high-level view of current work, blockers and upcoming actions. Keep your team's task board and approval records in their existing systems. This report draws out the few changes and decisions the recipient needs now.

Use written labels such as At risk, Complete and Conditional. Do not let a green badge imply that supplier bookings, costs or inspection approval are known when they are not. Mark unavailable budget totals clearly rather than filling them with zero.

Draft the weekly update from verified notes

Create one self-contained HTML weekly project status review copy.
Project, reporting dates, prepared timestamp and reader: [PASTE]
Actual accomplishments this week and evidence: [PASTE]
Change/blocker and consequence: [PASTE]
Decision: [owner | deadline | options | cost/date tradeoffs | conditions]; or NO DECISION NEEDED
Milestones: [name | original baseline | current forecast | owner | written status]
Next actions: [action | owner | due date | dependency]
Budget, scope and unresolved values: [PASTE]

Use only these facts. Preserve baseline dates; label conditional forecasts and proposed options. Compute calendar-day shifts with a consistent local calendar convention. Mark gaps [TO CONFIRM], never invent completion percentages, confirmed bookings, approval, cost savings or inspection results. Keep unknown amounts distinct from zero and additional shipping distinct from whole-project cost.
Lead with the current decision and deadline; show separate option summaries, then milestones and owner/date next actions. The page must not record approval or send anything. Use 16px body text, semantic headings, captioned tables with scoped headers and written statuses. Stack labeled rows at 360px without horizontal page overflow. Inline CSS only; no external assets, scripts, forms, editable fields or fake copy buttons. Preserve the existing tracker, required report format and decision records. Return complete HTML and unresolved questions.

Give the sponsor an update they can answer

Ask Mel which condition would change the decision. If the cost and date tradeoffs are unclear, read the two options together in the already prepared HTML report in NOS. Confirm supplier dates before revising the source tracker and report.

Send the revised option with a short explanation of what changed. Obtain the actual sponsor decision through the normal approval process and tell the owners which next actions it enables. Reading a report is not approving its recovery plan.
