Connect the dates before decorating them

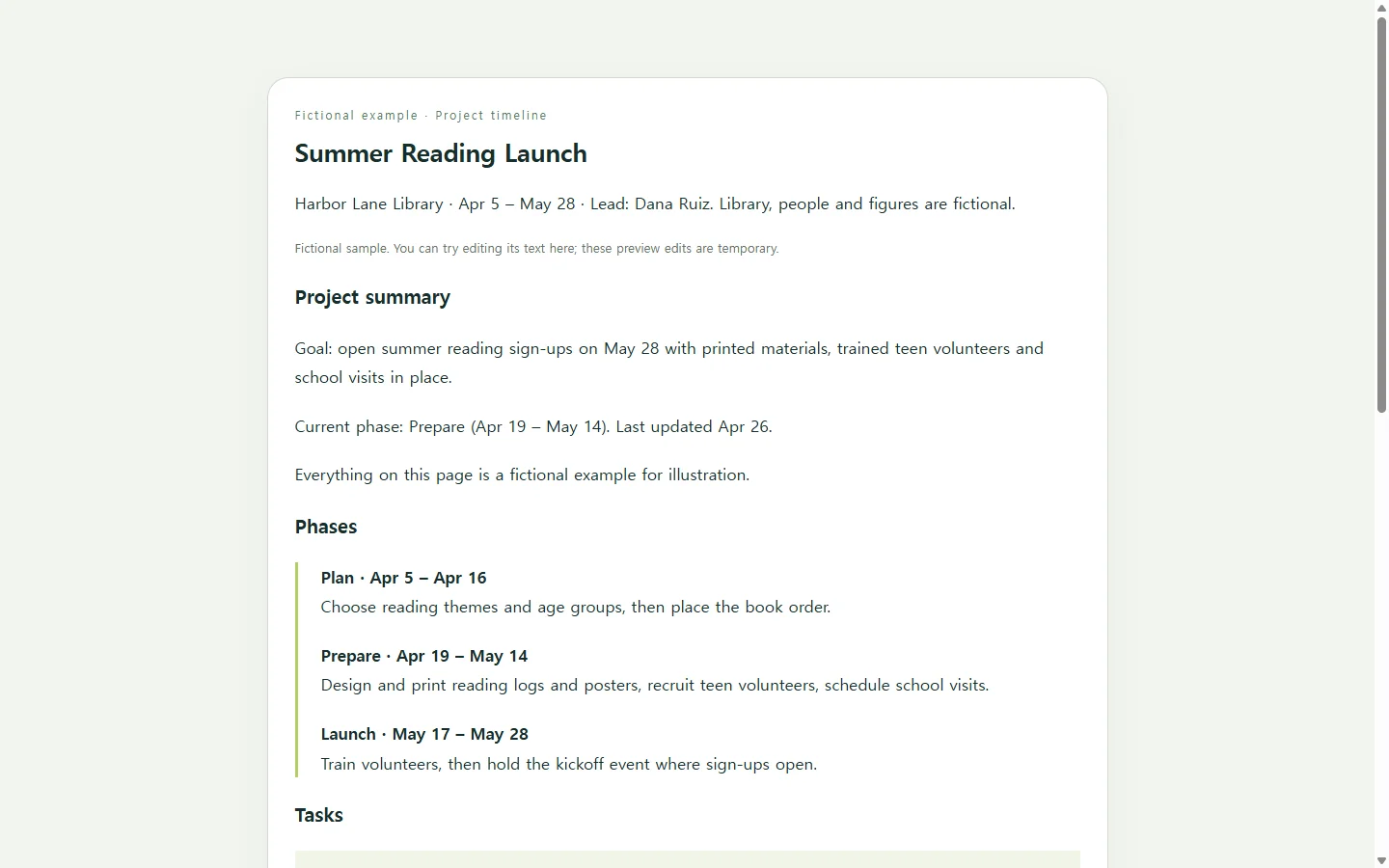

The fictional Northfield Library signup launch runs from November 2-27, 2026. Its seven tasks include work that can happen in parallel and work that must wait. The November 13 snapshot assumes nine of fifteen volunteer signups; people, counts and dates are illustrative planning data.

A planned start needs its prerequisites beside it. Training on November 17-18 follows both printing, targeted to finish November 16, and recruitment, targeted to finish November 13. With six volunteers still needed in the sample, that training date is conditional.
Use one duration convention
This page counts inclusive calendar days: end minus start, plus one. Brief approval on November 2-4 lasts three days; design on November 5-10 lasts six. Printing on November 11-16 also lasts six. A same-day signup milestone on November 27 counts as one day in the task table.
These are not working-day estimates. The full November 2-27 window spans 26 calendar days. Task durations total 35 because some tasks overlap; adding them does not measure project length or total staff effort.
Smartsheet's timeline template guide includes task owners, date ranges, durations, statuses and milestones. Use the fields that explain your actual schedule. Keep calculations and the authoritative dates in your project tool or spreadsheet; the review page is a snapshot.
Check the handoffs and the open risk
The seven rows preserve task IDs and written dependencies. Design follows brief approval, printing follows design, training follows printing and recruitment, and school visits follow training. The final signup launch follows the visits. The recruitment row can run alongside the design work; it does not need a fabricated predecessor.
Three milestones draw attention to brief approval on November 4, printed materials on November 16 and signup opening on November 27. The first is marked complete in the fictional snapshot; the latter two are targets, not guaranteed delivery dates.
If recruitment moves, ask the training owner which start is still workable. Do not just change November 17 and leave the school visits and final milestone unexplained. Recheck downstream dates and the resource calendar in the original tracker. Give the sponsor the PDF or presentation required for its meeting packet.
Draft from dated source rows
Create a single self-contained HTML project timeline review copy.
Project, goal, lead, reporting snapshot and overall dates: [PASTE]
Duration convention: [inclusive calendar days / supplied working calendar / supplied durations]
Tasks: [unique ID | task | owner | start | end | written status | predecessor IDs]
Phases and milestones, with actual/target labels: [PASTE]
Risks, source counts and decisions still needed: [PASTE]
Authoritative tracker and required submission format: [PASTE]
Use only supplied facts. Mark gaps [TO CONFIRM]. Validate dates, start/end order, unique IDs, predecessor references and dependency order; flag cycles or conflicts without silently changing source rows. Calculate only with the supplied duration convention; do not assume holidays or convert calendar days to effort. If dates are invalid, withhold derived durations. Preserve parallel work and label conditional starts.
Show a compact phase summary, a real captioned task table with scoped headers, milestone list and specific dependency questions. Use written statuses and at least 16px text. At 360px stack labeled rows without horizontal page overflow. Inline CSS only; no scripts, network, external assets, forms or native editable fields. This snapshot must not claim to update the source schedule. Return complete HTML and unresolved schedule checks.
Send a schedule the owners can question
Ask the training owner whether both prerequisites can be ready before November 17. If the handoff is hard to follow, read the dated rows and milestones together in the prepared HTML review copy in NOS. Confirm the answer in the source tracker before making a revised snapshot.
Send the changed dates with the downstream consequence. Ask affected owners to confirm their actions and give the sponsor the updated milestone forecast. Changing a review page is not notifying those people or rescheduling their work.
